- Page 2 - Page 3 - Page 4 - Page 5 - Page 6 - Page 7 - Page 8 - Page 9 - Page 10 - Page 11 - Page 12 - Page 13 - Page 14 - Page 15 - Page 16 - Page 17 - Page 18 - Page 19 - Page 20 - Page 21 - Page 22 - Page 23 - Page 24 - Page 25 - Page 26 - Page 27 - Page 28 - Page 29 - Page 30 - Page 31 - Page 32 - Page 33 - Page 34 - Page 35 - Page 36 - Page 37 - Page 38 - Page 39 - Page 40 - Page 41 - Page 42 - Page 43 - Page 44 - Page 45 - Page 46 - Page 47 - Page 48 - Page 49 - Page 50 - Page 51 - Page 52 - Page 53 - Page 54 - Page 55 - Page 56 - Flash version © UniFlip.com |
![]()
minimizing distortion | pnu’s apm unsymmetrical beams
The Unsymmetrical Precast Pre-Tensioned Beams For The Apm Bridge At Princess Nora Bint Abdulrahman University
by Essam Ayoub, Senior Bridge Engineer; Gamal Helmy, Bridge Department Head; Charles Malek, Director of Structures Department
Figure File
• Alignment length: 12.1 km • Concrete volume: 146,500 m3 • Construction period: • Pre-casting = 8 months • Construction = 8 months • Guideway Bridge • Straight sections: 8,800 m • Curved sections: 3,300 m • Precast concrete elements • slabs: 7,500 m3 with total number of ≈ 8650 units • C beams: 23,000 m3 with total number of ≈ 660 units • Segments: 6,500 m3 with total number of ≈ 810 units • Parapets: 11,500 m3 with total number of ≈ 8500 units • Cast in situ concrete elements • Foundations: 43,000 m3 • Piers: 18,500 m3 • Topping slab & stitching: 24,500 m3 • Concrete sleepers: 12,000 m3 • Pre-stressing and ordinary reinforcement • Pre-stressing reinforcement for all elements: 1,750 t • Ordinary reinforcement for all elements: 32,000 t

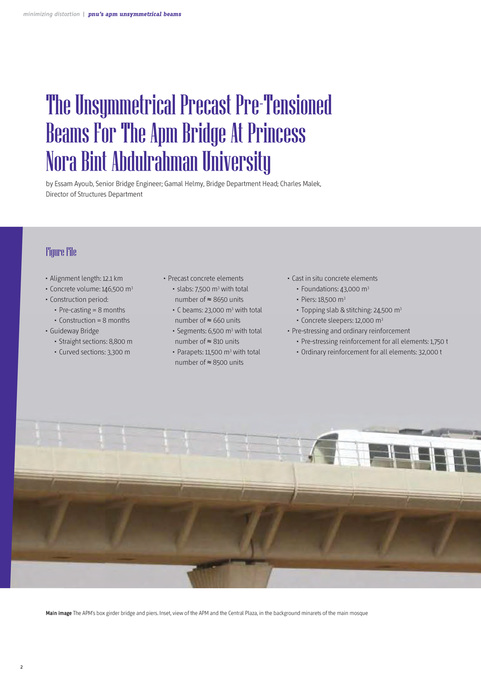

Main image The APM’s box girder bridge and piers. Inset, view of the APM and the Central Plaza, in the background minarets of the main mosque
